Contractor Management

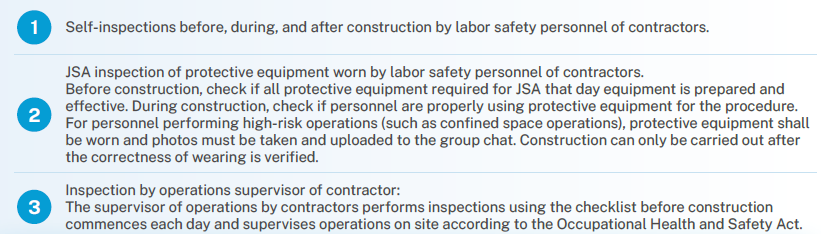

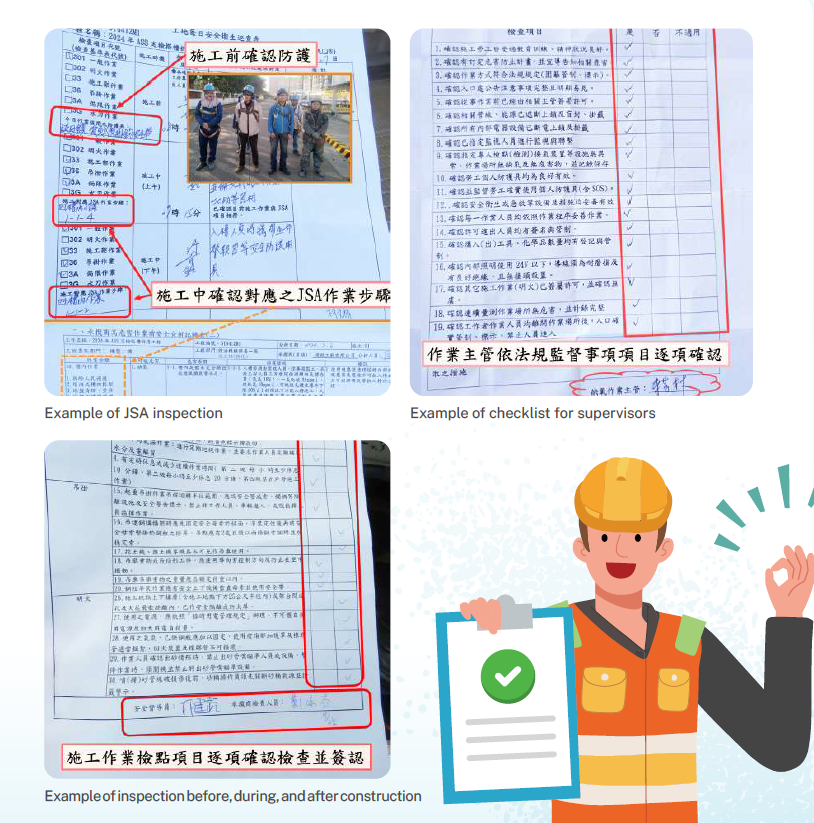

The Company convenes daily toolbox meetings and monthly coordination organization meetings to communicate, promote, and discuss safety and health with contractors. Requirements that must be immediately met are communicated through the messaging group between the Company’s engineering department and contractors. Contractors can use the group to ask questions at any time, and the Company’s personnel will immediately respond and provide assistance.



Continue to Implement Contractor Self-Management and Jointly Improve Self-Management Abilities of Suppliers

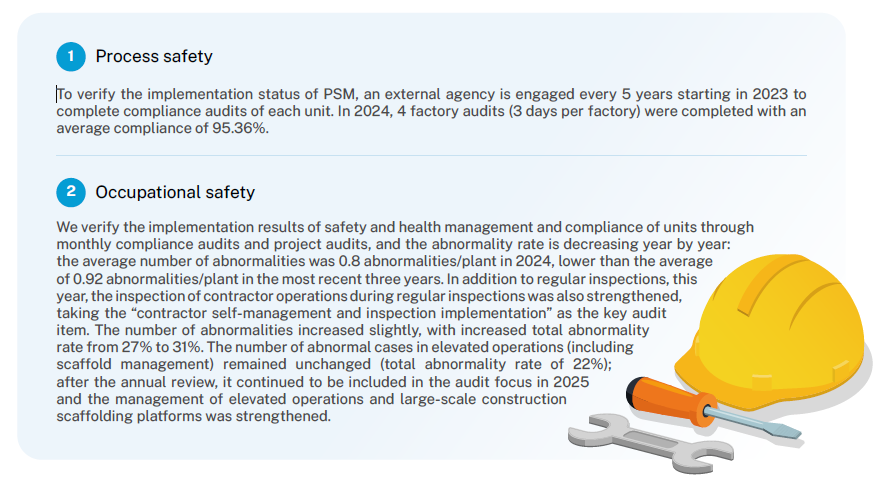

Compliance Audit

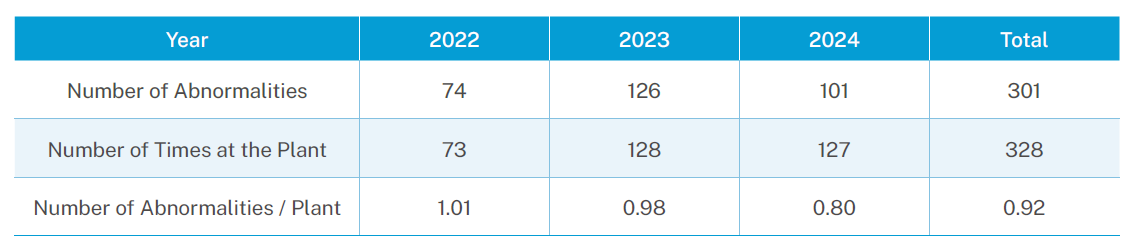

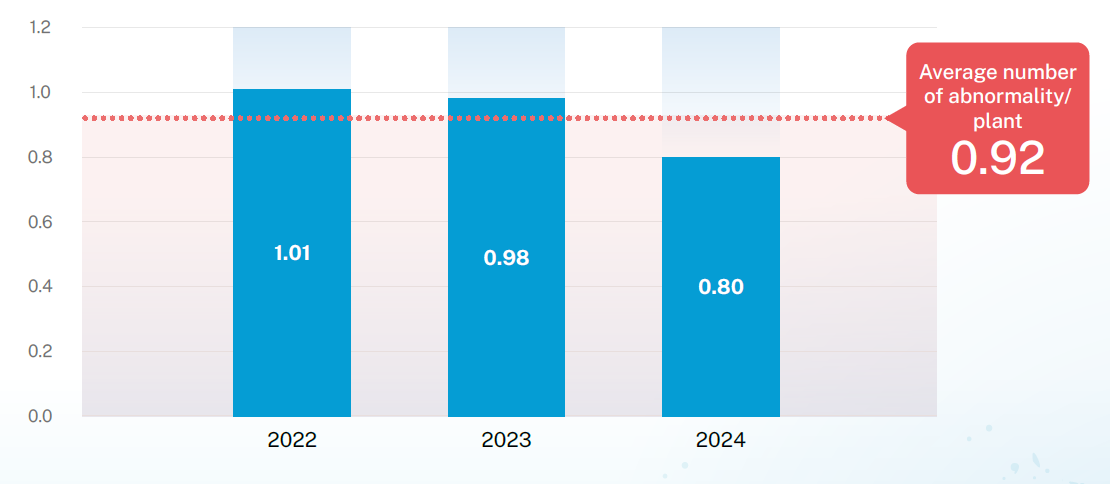

Average Number of Abnormalities in the Past 3 Years



Number of Abnormalities/Plant
